What Is a Certificate of Occupancy in NYC? When Do You Need It?

Go Back To Previous Page

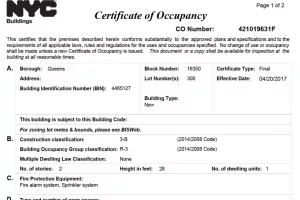

The 40-60 word answer: A Certificate of Occupancy (C of O, or CO) is a real estate document the NYC Department of Buildings issues to certify a building’s legal use and occupancy type — residential, commercial, or mixed-use — along with the number of permitted units. It confirms the property complies with building codes and is safe to occupy.

If a property doesn’t have the proper C of O, the city can issue a “Vacate Order.” That’s why understanding this document matters whether you’re buying, renting, or renovating in NYC.

Who Is Responsible for the Certificate of Occupancy?

The 40-60 word answer: The property owner is responsible for obtaining and maintaining a valid Certificate of Occupancy, including updating it after any renovation that changes the building’s legal use or unit count. For co-ops specifically, the Co-op Board is responsible for the building’s single C of O, not individual shareholders.

How Do You Get a Certificate of Occupancy in NYC?

In New York City, the Department of Buildings (DOB) issues certificates of occupancy after several inspections and the completion of all construction work. To obtain a CO, you must close allCertificate of Occupancy building permits and pass a final inspection. The CO is issued once the inspector confirms the construction is finished and the building is safe.

Obtaining a certificate of occupancy in NYC typically takes 6 to 12 months, though delays can push that well past a year.

What If Your Building Has an I-Card Instead?

Before 1938, New York City didn’t require Certificates of Occupancy for buildings, so some pre-1938 buildings still don’t have one. In those cases, an I-Card is usually accepted as the official record of the building’s occupancy.

Buildings with I-Cards may still need a Certificate of Occupancy if any legal alterations or conversions happened after the last date listed on the I-Card.

DOB provides Letters of No Objection (LNOs) to confirm the legal use of a building constructed before 1938. To request one, visit the DOB Borough Office where the property is located and bring documentation demonstrating the property’s longstanding use.

LNOs are issued when the proposed or actual use complies with NYC Building Codes and Zoning Resolutions, and the occupancy load and exits are unchanged.

What If Your Building Doesn’t Have an I-Card or CO?

A landlord can’t collect rent for units in a building without a valid Certificate of Occupancy, and can’t sue a tenant for non-payment as a result — though they can still pursue eviction through a holdover proceeding.

If you’re purchasing an apartment, you’ll need at least a temporary CO to begin financing, and most lenders require the final CO before approving funding. For new construction, budget for potential delays in getting that final CO.

Do You Have to Update Your CO When You Renovate?

If you’re planning significant renovations, or buying a property with renovation plans, updating the Certificate of Occupancy and pulling the necessary permits is essential. Any renovation that changes the number of rooms or the legal use of the building requires a permit — converting a two-family dwelling into a three-family by adding a basement apartment is a common example.

A qualified architect or engineer can review your renovation plans upfront to flag potential issues and confirm whether an updated C of O will be necessary for your specific project.

What If I’m Purchasing an “As-Is” or Bank-Owned Property?

When a property sells “as-is,” you’re typically responsible for correcting any C of O problems yourself. Review your purchase agreement carefully to understand the scope and cost you’d be taking on, especially once you’ve identified specific C of O issues.

NYC Certificate of Occupancy for Co-ops vs. Condos

Individual apartments in co-op buildings don’t have their own Certificates of Occupancy the way condo units do — the entire co-op building operates under a single C of O, and any issues with it are the Co-op Board’s responsibility, not an individual shareholder’s.

When buying a condo or most other building types, the title report typically identifies C of O problems. If issues arise, the usual next step is to hire an architect and an experienced expeditor to resolve them — a process that, even with an expeditor’s help speeding up the paperwork, can still take anywhere from three months to several years, depending on the building type and renovation scope.

Can a Landlord Collect Rent Without a Certificate of Occupancy?

In most cases, no. Tenants have the right to withhold rent if they discover they’re living in an illegal apartment. That said, a landlord can still collect rent if the property has a C of O violation that doesn’t pose an actual safety danger.

Penalty for No Certificate of Occupancy

The consequences in NYC are real. If the city discovers a landlord has rented out an apartment in a building without a valid C of O, it can issue an order to vacate, and the landlord may also face DOB violations and additional fines on top of that.

What Is a Temporary Certificate of Occupancy?

A Temporary Certificate of Occupancy (TCO) grants the same rights as a full CO, but only temporarily. TCOs are issued when a building, or part of one, is safe to inhabit even though outstanding work or permits remain before a permanent CO can be issued. Temporary COs are typically issued 90 days at a time and need to be renewed until the permanent CO comes through.

Certificate of Occupancy Documents at a Glance

DocumentApplies ToKey Detail
Certificate of Occupancy (C of O)Buildings completed after 1938, or renovated sincePermanent; states legal use and unit count
Temporary CO (TCO)Buildings safe to inhabit with outstanding work remainingIssued 90 days at a time until the permanent CO is ready
I-CardPre-1938 buildings without a C of OAccepted as the historical occupancy record
Letter of No Objection (LNO)Pre-1938 buildings confirming legal useIssued by DOB when use complies with current code

FAQ

How long does it take to get a certificate of occupancy in NYC?

Typically 6 to 12 months from application to issuance, though delays with inspections or outstanding permits can push that timeline well past a year.

Who is responsible for the certificate of occupancy in a co-op?

The Co-op Board, not individual shareholders — the entire building operates under one C of O rather than unit-by-unit certificates like a condo.

Can I sell a property without a valid certificate of occupancy?

You can, but it typically becomes the buyer’s responsibility to resolve under an “as-is” sale, so it’s worth understanding the scope and cost of any C of O issues before finalizing the purchase agreement.

What happens if I get caught without a certificate of occupancy?

The city can issue a vacate order, and the landlord may face DOB violations and additional fines on top of losing the ability to legally collect rent for the unit.

NYC Certificate of Occupancy Bottom Line

A NYC Certificate of Occupancy is an essential document every property owner needs to understand. This single piece of paper, easy to overlook, can be the difference between a tenant legally owing rent or an investor successfully closing on financing.

Knowing how to obtain and maintain a Certificate of Occupancy in NYC matters whether you’re renovating an existing property or constructing something new in the city.
